By Josh Fuller · September 22, 2026 · Service Upgrades
How Long Does an Electrical Permit Take in Yavapai County?
The short answer: It depends on which of five offices your address falls under. Inside the City of Prescott, a panel replacement permit is issued the same day under the Fast Track program. Prescott Valley and Chino Valley issue permits promptly and then the wait is for inspection, up to five days in Prescott Valley and next business day in Chino Valley. Dewey-Humboldt takes one to two weeks for approval. Unincorporated county addresses follow the county's PE-4 process, which adds an APS release step between inspection and reconnect.
The short answer: It depends on which of five offices your address falls under. Inside the City of Prescott, a panel replacement permit is issued the same day under the Fast Track program. Prescott Valley and Chino Valley issue permits promptly and then the wait is for inspection, up to five days in Prescott Valley and next business day in Chino Valley. Dewey-Humboldt takes one to two weeks for approval. Unincorporated county addresses follow the county’s PE-4 process, which adds an APS release step between inspection and reconnect.
Five offices, one county
Yavapai County is large, and the Quad Cities area alone has four incorporated jurisdictions plus the county itself, each with its own building department, its own submittal process, and its own inspection schedule. The permit for a panel or service upgrade goes to the office that has jurisdiction over the address, which is not always the office you would guess from the mailing address. A Prescott mailing address in Williamson Valley, for example, is unincorporated county, and the permit goes to the county, not the city.
Here is each one, with how it runs as of this writing. Fees are set by each office and pass through on the quote. We leave the amounts to them.
City of Prescott: same-day Fast Track

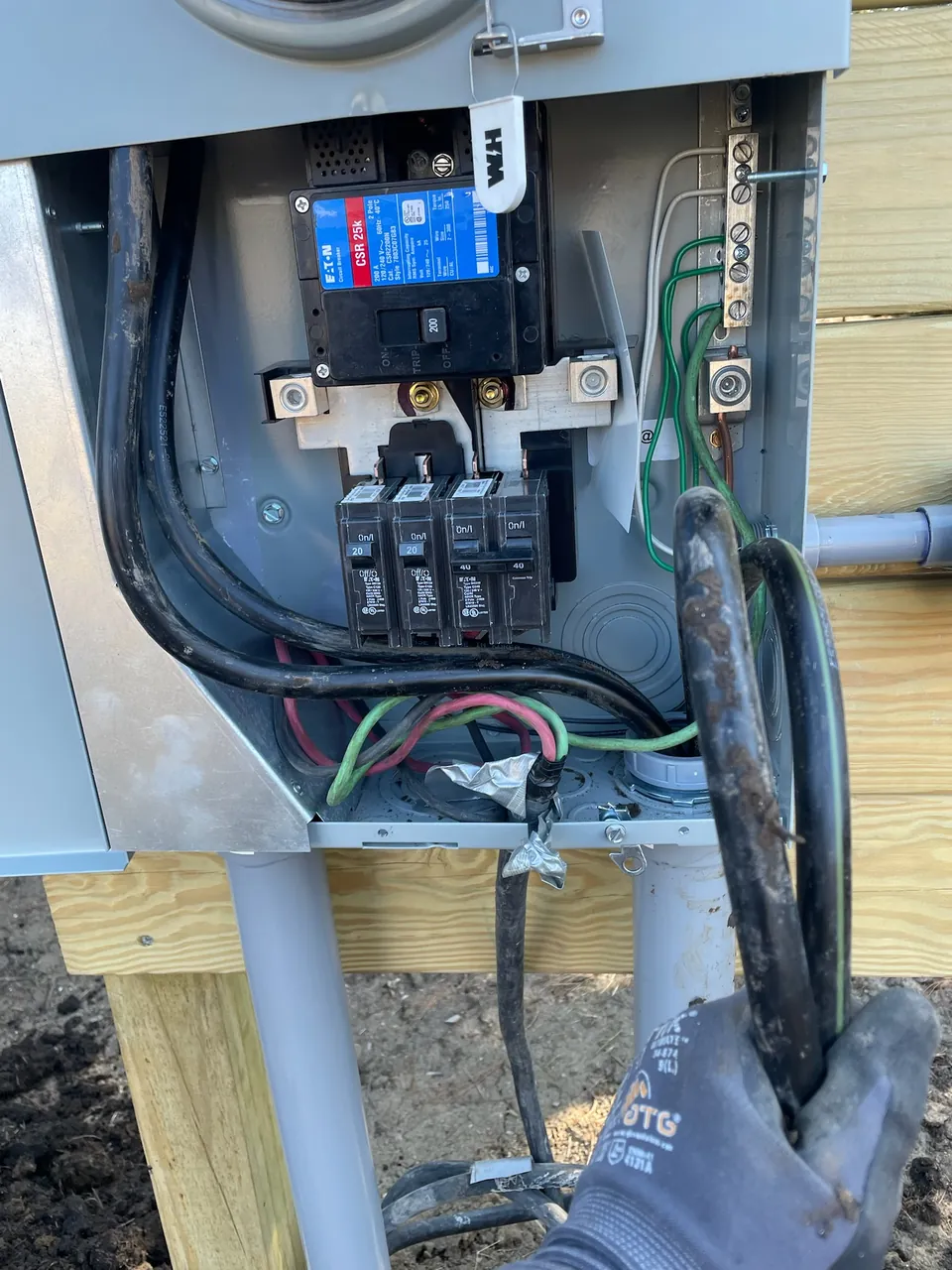

The permit office is the Community Development Building Division at 201 N Montezuma St, downtown. A permit is required for a panel replacement, and since July 2026 the City runs a Fast Track program: an electrical panel replacement up to 200 amps, filed in person before 3 p.m., is issued the same day. Service entrance upgrades up to 200 amps are a separate permit category, so a 100 to 200 amp service change is filed under that heading.
Either way, the permit is not the long pole in Prescott. The inspection scheduling and the APS reconnect are. For an insurance-driven replacement with a deadline, this is the best case in the county, and it is one reason we lead with panel work in the City of Prescott.
Town of Prescott Valley: a five-day inspection window
Prescott Valley’s Development Services office is at 7501 E Skoog Blvd. Electrical permits there cover new services, replacements, and resizing, which means a straight panel swap and a 100 to 200 amp upgrade are both permitted work. Once the permit is issued and the work is done, inspections are requested up to five days ahead, with a 6:30 a.m. cutoff for same-day requests.
In practice that means we schedule the inspection when we schedule the job, so the inspector is lined up for the afternoon the work finishes or the next morning. Miss the 6:30 cutoff and the inspection slides a day.
Town of Chino Valley: next-business-day inspections
Chino Valley’s Development Services is at 1982 Voss Dr. The town works under the 2024 International Residential Code and the 2023 National Electrical Code, which is current. Inspections requested before midnight are scheduled for the next business day, which is the fastest inspection turnaround in the area.
That matters in Chino Valley because a service upgrade on an acreage lot often includes a well pump circuit, a shop feeder, or both, and getting the inspection the next day means the APS reconnect is not held up waiting on it.
Town of Dewey-Humboldt: one to two weeks
Dewey-Humboldt’s Building Safety office is at 2735 S Highway 69, Suite 12, in Humboldt. Approvals run one to two weeks. It is a small town office, incorporated in 2004, and the review is not instant the way Prescott’s Fast Track is.
This is the jurisdiction where we tell people to start early. If an insurer has given you 30 days to replace a Zinsco panel in the Prescott Country Club area, one to two weeks of permit review eats a real share of that window, and the job, the inspection, and the paperwork still have to fit in what is left. Our Dewey-Humboldt page has more on the town’s housing and what we expect to find there.
Unincorporated Yavapai County: the PE-4 process
Williamson Valley, Walker, Groom Creek, Paulden, and the other unincorporated areas go through Yavapai County Development Services at 1120 Commerce Dr in Prescott. The county adopted the 2024 I-codes and the 2023 NEC effective January 1, 2026.
For electric service upgrades, the county has a specific policy, PE-4, and the sequence matters. We schedule the upgrade inspection. The inspector comes out and, if the work passes, tags the service for release. The county then emails the release to APS. APS reconnects or sets the meter, and a final inspection follows.
That release step is the difference between the county and the towns: the inspector’s approval goes to APS through the county rather than through us, so the reconnect waits on the county’s email. It is a reliable process, but it adds a step, and we plan the outage around it.
What the timeline looks like from permit to power
A permit is only the first date on the calendar. The full sequence for a service upgrade is permit, APS scheduling for the disconnect, the working day, the inspection, the release, and the reconnect. For a panel replacement that keeps the existing service, the APS side is simpler, usually a meter pull and reset, and the inspection is the main event.
The office decides how fast the permit and the inspection move. APS decides the disconnect and reconnect dates. We control everything in between, and the way we keep the total short is by requesting the inspection the moment the job is scheduled rather than the day it finishes.
What slows a permit down
Most delays start with the application, not the office.
- Wrong jurisdiction. Filing with the city for a county address, or the reverse, restarts the clock. We verify the jurisdiction from the parcel, not the mailing address.
- No load calculation. A 200 amp service upgrade application without a load calculation is incomplete. We run it before we file.
- Scope mismatch. Filing a panel replacement when the job is really a service entrance upgrade, or the other way around, means the wrong permit category and a return trip.
- APS coordination missing. A service upgrade that changes the meter socket or service point needs APS lined up. Getting the permit first and calling APS second adds days.
- Work done without a permit. An unpermitted panel that surfaces during an insurance inspection or a home sale has to be permitted after the fact, and that review can take longer than the original would have.
Why we pull a permit on every job
Every panel replacement and every service upgrade we do is permitted and inspected, and the reasons are practical rather than ceremonial. The finaled permit is the document your insurer wants when it asks for proof that a Federal Pacific or Zinsco panel is gone. It is the document a buyer’s inspector looks for when you sell. And an inspector’s second set of eyes on a service upgrade, especially the grounding and the service conductors, is worth the visit. Skipping it saves a fee and costs you the paper trail.
If you are planning a panel upgrade and want to know which office your address falls under and what the realistic calendar looks like, text us photos of the open panel and the meter along with the address, and we will send back a written estimate with the permit path spelled out.
Want us to look at your panel?
Text photos of the open panel and the meter. Written quote within one business day, permit included.
Related questionsStraight answers
Do I need a permit to replace an electrical panel in Yavapai County?
Yes, in every jurisdiction here. The City of Prescott, the towns of Prescott Valley, Chino Valley, and Dewey-Humboldt, and unincorporated Yavapai County all require a permit for a panel replacement or service upgrade, and each inspects the finished work. The finaled permit is also what insurers and home buyers ask for as proof.
How fast is a panel replacement permit in the City of Prescott?
Same day, when it qualifies. The City's Fast Track program, in place since July 2026, issues permits for electrical panel replacements up to 200 amps the same day if the application is filed in person at 201 N Montezuma St before 3 p.m. Service entrance upgrades up to 200 amps are a separate category with their own permit.
Who handles the permit for a home with a Prescott address but outside the city?
Yavapai County Development Services at 1120 Commerce Dr in Prescott. Williamson Valley, for example, carries a Prescott mailing address but is unincorporated, and Walker, Groom Creek, and Paulden are county as well. Service upgrades there follow the county's PE-4 policy, where the inspector tags the service for release and the county emails that release to APS.
How long does the whole process take, from permit to power back on?
The permit is the quick part in most of these offices. The full sequence for a service upgrade is permit, APS disconnect scheduling, the working day, inspection, release, and reconnect, and the inspection and APS dates set the pace. Prescott and Chino Valley move fastest. Dewey-Humboldt adds one to two weeks of review up front.
